Set Up Daily Tasks

4 min read

What is this?

A daily task tells Clue what the trucks do in a shift. Each task has a load Area, a dump Area, a material and a time window. Clue uses the tasks to count loads and to sort them by material. You set the tasks for each date and shift.

The Tasks view with the daily tasks of Nov 12, 2026

Who's this for?

  • Superintendents, plan the haul routes for each shift.
  • Foremen, check where the trucks load and dump today.
  • Project managers, keep the plan correct so the counts are correct.

How to use it

Step 1: Open the Tasks view

Open a project in Operations > Production and click Tasks. The page shows the tasks for the date and shift.

The Tasks view with the daily tasks of Nov 12, 2026

Step 2: Edit the tasks

Click Edit. Click Add New to add a task. Use the ... menu on a task to change it.

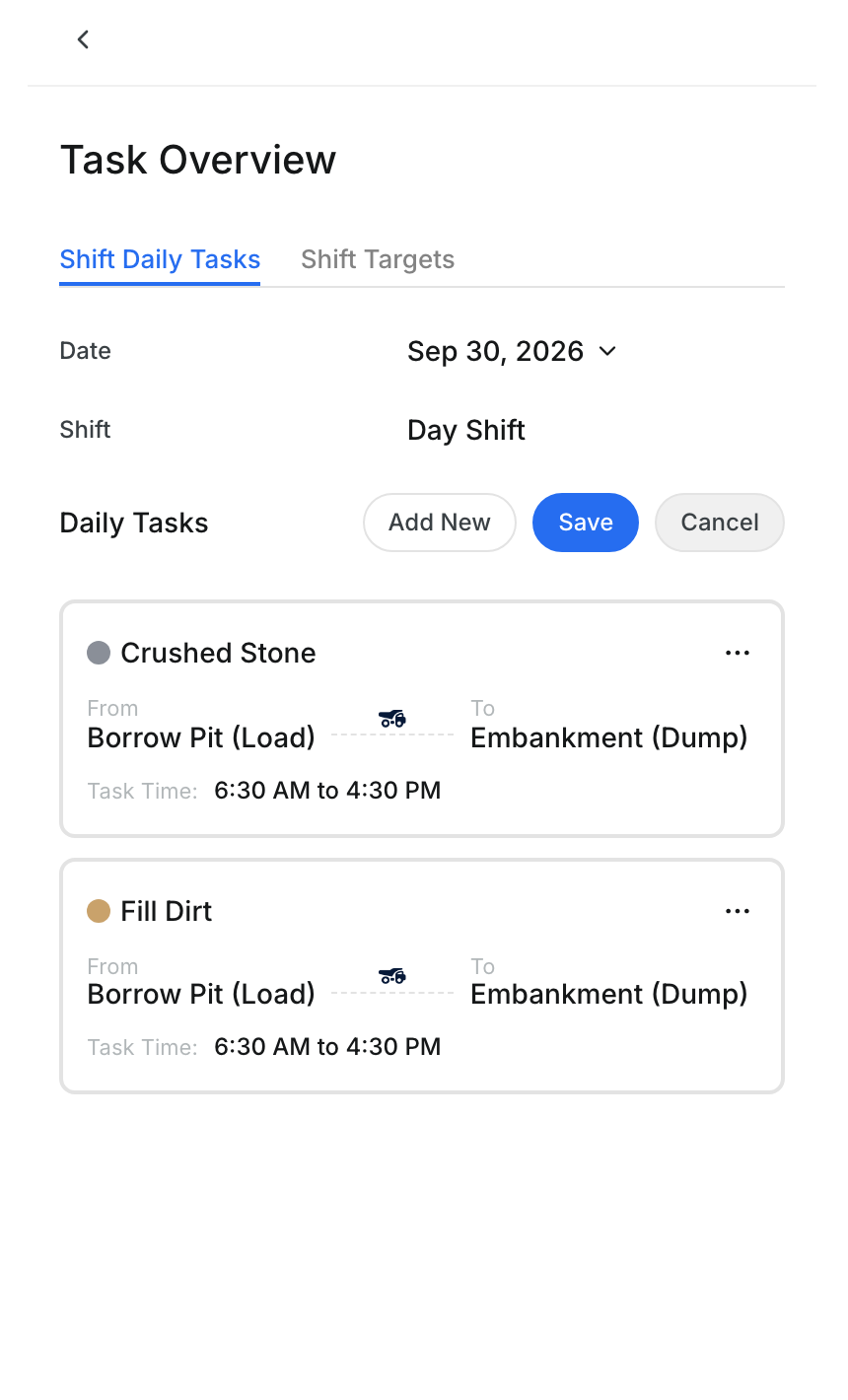

The Tasks view in edit mode with Add New, Cancel and Save

Step 3: Set the route and material

In New Daily task, pick the From Location where trucks load. Pick the To Location where they dump. Pick the Material Type.

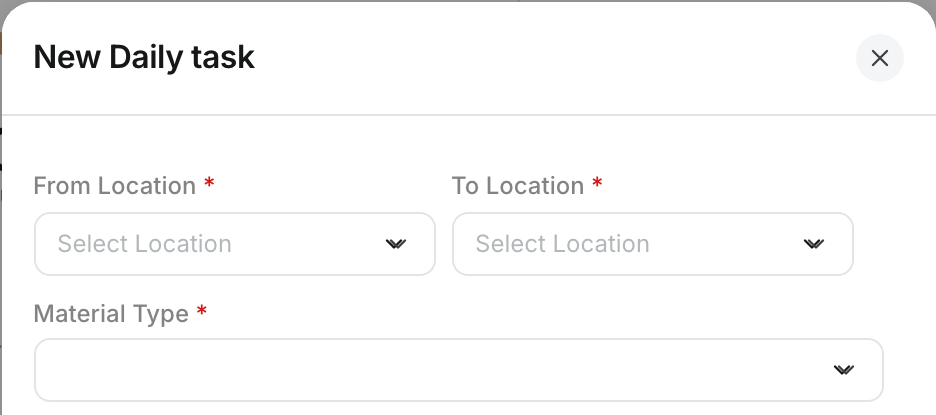

The New Daily task window with From Location, To Location and Material Type

Step 4: Set the time window

Under Advanced Settings, set the Start Time and End Time. You can also pick a Designate Loading Unit and a Cycle Time Target. Click Save, or Cancel to close.

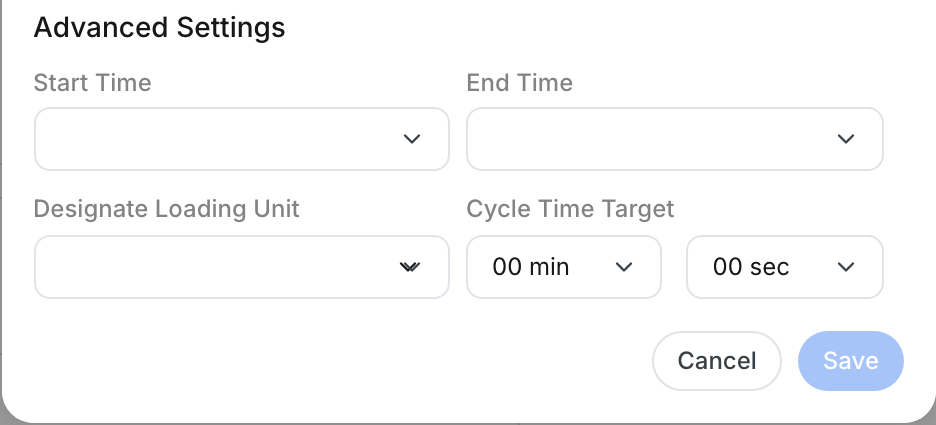

Advanced Settings with Start Time, End Time, Designate Loading Unit and Cycle Time Target

Tasks on the same route can touch. One task can end at 2:45 PM and the next task can start at 2:45 PM.

Two Waste tasks on the same route, 7:15 AM to 2:45 PM and 2:45 PM to 5:00 PM

Step 5: Clear the Advanced Settings

Click Clear on the right side of the Advanced Settings heading. One click clears the Start Time, End Time, Designate Loading Unit and Cycle Time Target.

The empty times show Whole Shift. The task now covers the whole shift. Click Save in the window, then click Save on the page.

The Edit Daily task window after Clear, with Whole Shift in Start Time and End Time

Step 6: Fix a refused Save

Two tasks on the same route cannot use the same loading unit at the same time. Two tasks on the same route with no loading unit can overlap only when the materials are different. When your changes break this rule, Clue does not save. A message names the other task.

The message that names the other task with the same route

Delete one of the two tasks with the ... menu, or change its times or loading unit. Then click Save again. Your other changes stay on the page.

Step 7: Fix a task with a deactivated Area

A task that uses a deactivated Area shows a Deactivated tag on the card.

A Fill Dirt task with the Deactivated tag under NE Dump

Open the task with ... and Edit. The Area shows (Deactivated). Pick an active Area, or delete the task.

The Edit Daily task window with NE Dump (Deactivated) in To Location

The full details

  • Date: The task date. It starts on the date of the project page.
  • Shift: The shift for the tasks.
  • From Location: The load Area. You draw Areas in Site Map.
  • To Location: The dump Area.
  • Material Type: The material the trucks haul on this route.
  • Task Time: The time window of the task, for example 6:30 AM to 4:30 PM. A task with no times covers the whole shift. The window shows Whole Shift.
  • Designate Loading Unit: The loader that fills the trucks on this task.
  • Cycle Time Target: The planned time for one full truck trip.
  • Clear: Clears the Start Time, End Time, Designate Loading Unit and Cycle Time Target of one task. The link shows only when one of them has a value.
  • Overlap rule: Two tasks with the same From Location, To Location and Designate Loading Unit cannot overlap in time. Tasks with no loading unit can overlap only when the Material Type is different. Touching times are allowed.
  • Deactivated Area: A task with a deactivated Area shows a Deactivated tag. You can change its other fields. To count loads again, pick an active Area or delete the task.
  • Change Task: When you change the tasks, Clue updates the productivity numbers for that date and shift.

Tips

  • Draw the load and dump Areas in Site Map before you add tasks.
  • Add one task for each material on the same route.
  • To set a load target for one asset, click Edit, then New Load Count Target on the task.
  • Use Clear when a task runs all shift and has no fixed loader.
  • If Save is refused, read the message. It names the task to delete or change.
