If you manage heavy construction equipment, you already know the painful truth: downtime rarely stays “small.” A delayed start on an excavator turns into idle trucks, missed compaction windows, rushed finishing, and a crew that spends the day recovering instead of producing.
That’s exactly the problem Total Productive Maintenance (TPM) was designed to solve: create a repeatable system that reduces unplanned stops and makes equipment performance predictable, not hopeful.
This is a jobsite-first guide to the 8 TPM Pillars: how they work, what “good” looks like for heavy fleets (excavators, dozers, loaders, graders, rollers, telehandlers, cranes), and how to implement them without turning your shop into a paperwork factory.
Total Productive Maintenance (TPM) is a reliability operating system that keeps heavy equipment (excavators, dozers, loaders, cranes, compactors) ready, running at planned pace, producing spec work first pass, and safe to operate by combining operator-led care, planned maintenance, problem elimination, training, and admin workflow discipline.

The eight pillars of TPM form the foundation of an effective maintenance system. Each pillar targets a specific area of equipment reliability and operational discipline, and together they reduce the big losses that hit production: breakdowns, minor stops, slow running, quality defects, and safety incidents.
In construction terms, these pillars eliminate the “hidden leaks” in production capacity: breakdowns, slow running, rework, safety exposure, and administrative waiting.

Manufacturing teams often use OEE. Heavy construction can translate the same logic into four questions your superintendent, dispatcher, and shop lead can agree on:
“Ready” means it starts on time, passes basic checks, and is physically present where it is scheduled. A dozer that starts at 9:00 a.m. is not “available,” even if it runs perfectly afterward.
A loader that is “operational” but overheats, derates, or needs constant rework by the operator is quietly eating your production curve.
Over-excavation, grade drift, compaction failures, and lift-plan rework are not “quality issues.” They are downtime in disguise.
In TPM, safety is not a separate initiative, it is part of the same objective (stable operations, zero surprises).
TPM only works when ownership is clear. Use this simple split:
TPM came from plant environments, but construction adds three realities TPM must be built to handle:
A strong TPM program doesn’t fight variability with more paperwork. It wins by creating standards that still work when the site is chaotic.

TPM is not a “maintenance initiative.” It is an operating discipline that makes equipment performance predictable instead of hopeful. When the pillars are executed with real routines and real follow through, the benefits show up in the same six areas every jobsite fights daily.
More machines ready when the plan says they should be ready. That means fewer delayed starts, fewer emergency swaps, and less time spent reshuffling crews because one unit did not show.
TPM does not just reduce breakdowns. It reduces the soft losses that drain output, derates, overheating recoveries, constant small stops, and operator workarounds that stretch cycle times all day.
When equipment stays inside capability limits, you get fewer grade corrections, fewer compaction do overs, fewer over excavation fixes, and fewer rushed closeout days caused by preventable machine condition issues.
The win is not “we repaired it.” The win is “that failure pattern stopped coming back.” TPM shifts work toward planned interventions, reduces repeat repairs, and improves parts readiness so labor hours produce results instead of comebacks.
A stable machine is a safer machine. TPM tightens the link between condition and safety by pushing defect discovery earlier and driving faster closure on safety critical issues before they become incidents.
When operators know what to look for and technicians get planned windows with parts ready, the whole system becomes calmer. Less chaos, fewer urgent calls, and fewer days where the shop is reacting to whatever broke loudest.
A construction fleet can make real progress in 90 days if it sequences work correctly:
Pick five schedule-critical assets. Launch operator care checks, define defect triage rules, and start tracking downtime minutes per unit.
Build PM plans, institute a weekly planning rhythm, and kit common parts. The goal is fewer “waiting” hours: waiting on parts, approvals, or technician availability.
Run focused improvement events for repeat problems, add quality capability thresholds for spec-critical machines, and tighten administrative workflows so repairs close cleanly.
Track weekly on the 5 most schedule-critical assets:
Weekly review rule: pick one loss, assign one owner, set one due date, confirm it next week.

In construction, TPM does not fall apart because the pillars are wrong. It falls apart when the rollout is not run like a jobsite system. These are the five problems that show up most often, and the simple moves that prevent them.
If operators feel TPM is “extra work,” checks get skipped and defects stop getting reported. Keep the routine short, train on what to look for, and prove it works with one early win on a schedule critical machine.
If everything is urgent, planned work never wins. Roll out in phases, start with a small set of critical assets, and protect one weekly planning rhythm so PMs and planned repairs actually happen.
TPM depends on early detection and clean diagnosis. Build skills in small steps: operator signals and reporting discipline, technician troubleshooting and repeat failure elimination. Use OEM procedures as the reference, but standardize how your fleet executes in the field.
If downtime reasons live in texts and memory, you get arguments instead of improvement. Set a baseline, then capture the same basics every time: asset ID, downtime minutes, reason, and what decision was made. Track leading indicators that predict reliability, not just month end totals.
TPM dies when it is treated like a campaign. Make it normal work: standard routines, light audits on critical assets, and a weekly scorecard review where one loss gets one owner and one due date. Consistency beats intensity.
Focused Improvement is structured problem-solving to eliminate the few losses that create most of your disruption. It’s the difference between “we fixed it again” and “it stopped happening.”
Focused Improvement projects often target recurring patterns such as:
An excavator overheats twice a week. The field response is always the same: blow out the radiator, get it back to work, repeat next week. Focused Improvement turns it into a short project:
The “win” is not the repair; it’s the new standard that prevents recurrence.
Run Focused Improvement like a short PDCA sprint. Start by defining the loss in minutes, trial one countermeasure, convert what works into standard work, and audit it long enough to confirm the problem stays gone. The key is restraint: tackle one equipment class and one recurring issue at a time so results are obvious and repeatable.
Autonomous Maintenance puts routine care into operator hands: cleaning, inspection, lubrication checks, minor adjustments, and early abnormality detection. Lean Production’s TPM overview describes this pillar as giving operators responsibility for routine maintenance tasks such as cleaning, lubricating, and inspection.
Most catastrophic failures are not “instant.” They start as small evidence: a fresh seep, heat smell, loose fastener, worn cutting edge, chafing hose sleeve, abnormal vibration. Operators see those signals first, if they know what to look for and if reporting actually triggers action.
The best operator routine is short, visual, and tied to risk:
Look for fresh hydraulic seepage at routing points, track tension markers, coupler engagement, bucket tooth wear, unusual swing noise, and belly-pan accumulation that hides leaks.
Scan undercarriage condition, track tension, blade/ripper pin health, cooling package cleanliness, and leaks under the belly.
Inspect articulation areas, tires, brake response, bucket pin play, and hose chafe points around boom articulation.
Confirm function checks, outriggers/pads readiness, basic rope/hook visual condition as required by your program, and reinforce wind/ground rules before work starts.
For cranes and lifting equipment, follow your regulatory inspection program and OEM requirements. This guide supports those routines, it does not replace them.
Every reported defect must receive a disposition the same shift, so operators know reporting leads to action:
If reported defects vanish without a visible decision, operator engagement collapses and autonomous maintenance fails.

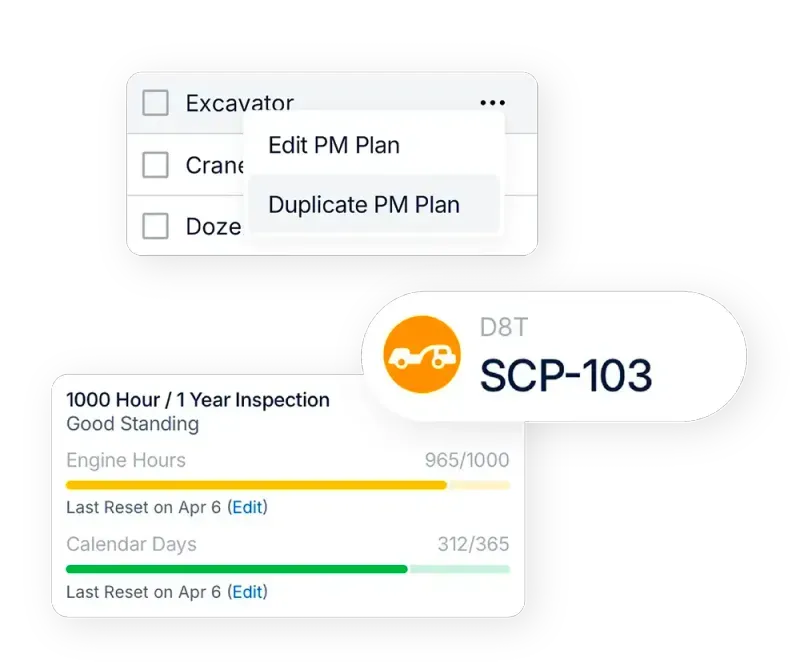

Planned Maintenance schedules preventive and predictive work at the right times, with parts and labor prepared. This is where fleets stop gambling.
A planned system typically includes:
Hold a 30–45 minute weekly session with the superintendent (or dispatcher) and the shop lead to:
This cadence often reduces MTTR because technicians arrive with the right parts and a defined work plan, not guesswork.
These are practical starter targets, not universal industry standards. Adjust them based on your fleet size, utilization, and jobsite conditions.
Example: a 500-hour PM is still “on time” if you complete it by 550 hours.
Track: breakdowns per 100 operating hours
Example: 6 breakdowns in 420 hours → 6 ÷ 4.2 = 1.43 per 100 hours
Quality Maintenance ensures equipment can produce within spec, consistently. It prevents defects by maintaining the conditions required for quality output.
Quality problems rarely feel like downtime until closeout, when everyone is reworking under pressure. TPM pulls quality upstream.
Instead of vague statements (“grader feels sloppy”), define measurable conditions:
Blade wear limits, control calibration cadence, steering play thresholds, articulation drift checks.
Hydraulic drift thresholds that drive over-excavation, coupler alignment integrity, bucket wear standards.
Verification cadence for amplitude/frequency settings, drum condition, consistent spray/water system behavior where relevant.
Inspection and calibration discipline plus lift planning practices that prevent damaged loads and rework.
Pick your top two rework drivers and ask: what machine conditions must be true to prevent this? Then write:
Early Equipment Management (also called Initial Management) prevents reliability problems from being designed into new purchases and rebuilds. JIPM’s TPM award outline references “initial management” as one of the 8 pillar activity areas.
Fleets win when they reduce one-off complexity:
When you buy a new machine, don’t assume it’s “fully settled” on day one. Treat the first 250–500 operating hours as a trial period where you learn what the machine really needs in your environment.
During that period, do three things:
Write down every fault, leak, sensor issue, overheating event, or unusual wear that shows up in the first few weeks.
Operators notice what slows them down: hard-to-reach grease points, poor visibility, nuisance alarms, attachment fit issues, or controls that cause extra wear.
Use what you learned to improve the machine’s PM schedule, parts list, and setup standards (for example: change cleaning frequency in dusty work, add a hose-protection step, stock a common sensor, standardize an attachment procedure).
Over time, this approach reduces “new machine surprises” and makes each future purchase easier to maintain because you build a smarter standard every time.

Training creates the capability to run the system. TPM expects operators to detect abnormalities and technicians to diagnose efficiently, and both require consistent development.
Two tracks are usually enough to start:
Daily checks, safe operation habits that reduce wear, early warning signs, and defect reporting discipline.
Hydraulic troubleshooting, electrical diagnostics, OEM procedures, and failure analysis basics (so repeat repairs shrink).
Add a leadership module for foremen/superintendents: triage rules, downtime window planning, and how to enforce standards without fighting production.
SHE is a core TPM pillar because “zero accidents” is part of the TPM intent in many descriptions of the framework.
Many serious incidents start with a maintenance issue. In other words, the machine was already giving warning signs, but the condition wasn’t fixed in time. Common examples include:
For cranes and lifting equipment, safety also depends on doing the “planning work” every time: confirming the lift plan, checking ground stability for outriggers, following wind limits, inspecting rigging, and keeping people out of the exclusion zone.
Office TPM removes administrative losses that keep assets down: missing parts, slow approvals, unclear work orders, and weak coordination between field and shop. JIPM-related materials include administrative/supervisory functions as one of the pillar activity areas.

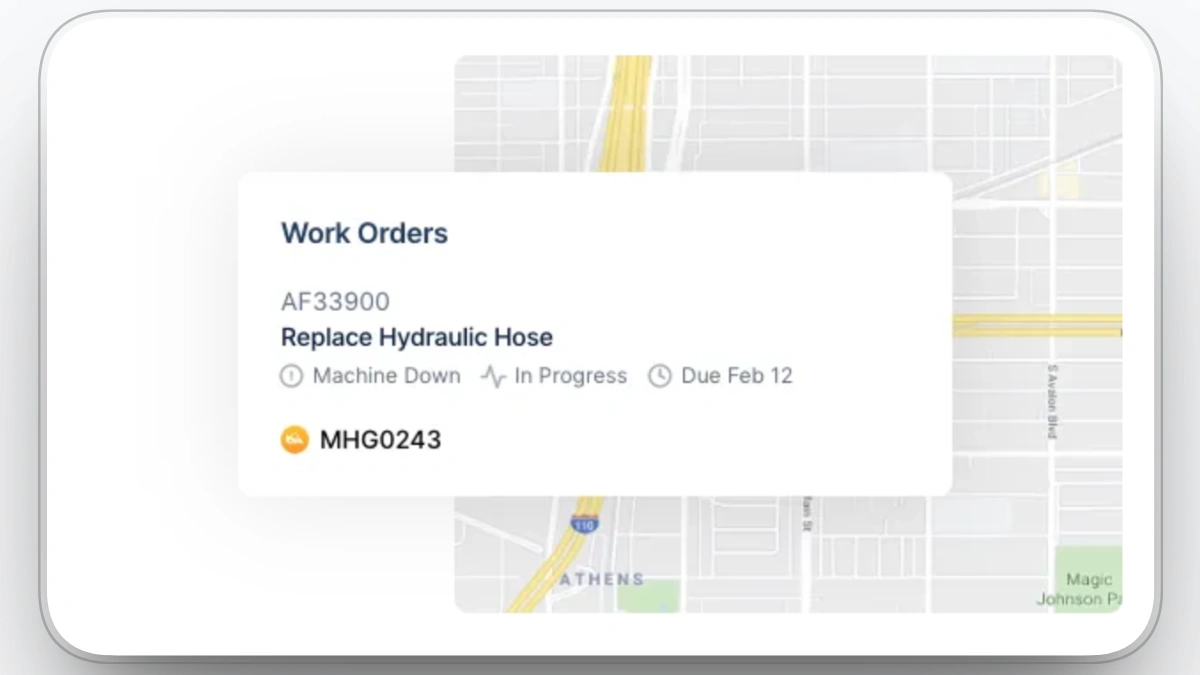

Sometimes the machine isn’t down because the repair is hard. It’s down because the process is slow. A unit can be easy to fix and still sit idle because:
To eliminate this “waiting downtime,” put three basics in place:
Once you’ve defined the TPM routines and KPIs, the next challenge is consistency. In construction, TPM usually breaks down for one reason: the work is happening, but the proof is scattered, paper checklists in trucks, work orders in texts, PM reminders in someone’s head, and downtime notes that never reach the shop.
The goal is simple: make TPM actions easy to do in the field and easy to see in the office. That’s where a fleet management system like Clue can help; not as “extra software,” but as the place your TPM routines live so the scorecard is based on real activity.
Here’s how it supports the pillars you’re already running:
%20Inspections%20Management.webp)

In other words, the technology supports TPM when it reduces friction: fewer missed checks, fewer undocumented defects, clearer work orders, and better visibility into what is planned versus what is emergency.
Choose five critical machines. Launch operator checks, build PM plans, and run one focused improvement event on the most painful repeat problem. Review the scorecard weekly. Within a month, you should see fewer start-of-shift surprises. Within a quarter, you should see planned work overtake reactive work on the assets that control your schedule.
That is the practical promise of the 8 TPM Pillars: a steadier fleet, a steadier jobsite, and far fewer days lost to avoidable chaos.
Autonomous Maintenance is the operator-led layer (clean, inspect, tighten, basic checks) designed to catch abnormalities early, while Planned Maintenance is the maintenance-team-led layer that schedules PMs, repairs, and condition-based tasks so work is done deliberately instead of reactively.
No. Preventive maintenance is one component inside TPM. TPM is broader because it combines PM with operator-owned maintenance, focused improvement (kaizen), quality-focused controls, training, safety, and administrative process improvements, so reliability becomes an organization-wide system, not just a maintenance calendar.
TPM is the operating model that builds daily discipline and shared ownership across the whole fleet. RCM is a deeper analysis method used to choose the “right” maintenance tasks based on failure modes, consequences, and cost, often best reserved for high-criticality assets (e.g., cranes, specialty rigs, mission-critical production spreads).
